Keep every fence-project change tied to the right baseline.

Record what was proposed, what changed, who decided it, which revision became effective, and which drawings, quantities, orders or delivery instructions still need updating.

This is an administrative project record. It is not a contractual change order, engineering approval, permission to proceed, price agreement or product-acceptance document. The project’s authorized process controls those decisions.

A verbal move of one gate can affect the route drawing, line length, post count, quotation and delivery. One dated change ID makes that chain visible without overwriting the earlier basis.

1. Freeze the current baseline

Start with the exact records the team believes are current. Use the project planner and measurement record to identify the route and quantity basis.

Project / location____________________________
Change IDCHG-________
Date raised____________________________
Raised by / contact____________________________
Baseline drawing / recordID ______ Rev ______ Date ______
Related quote / POID ______ Rev ______ Date ______
Requested decision by____________________________
Current action owner____________________________

2. Describe the before and after states

Change definition
Affected itemBefore / baseline valueProposed new valueReason and evidenceSource record
Route / boundary / section________________________Drawing / survey ______
Gate / access / crossing________________________Sketch / photo ______
Quantity / unit________________________Takeoff ______
Product / specification________________________Data sheet / quote ______
Packaging / delivery________________________PO / instruction ______

Use one unit system per value and name the exact source. If the new value is not yet known, record the question and owner instead of replacing the baseline with a guess.

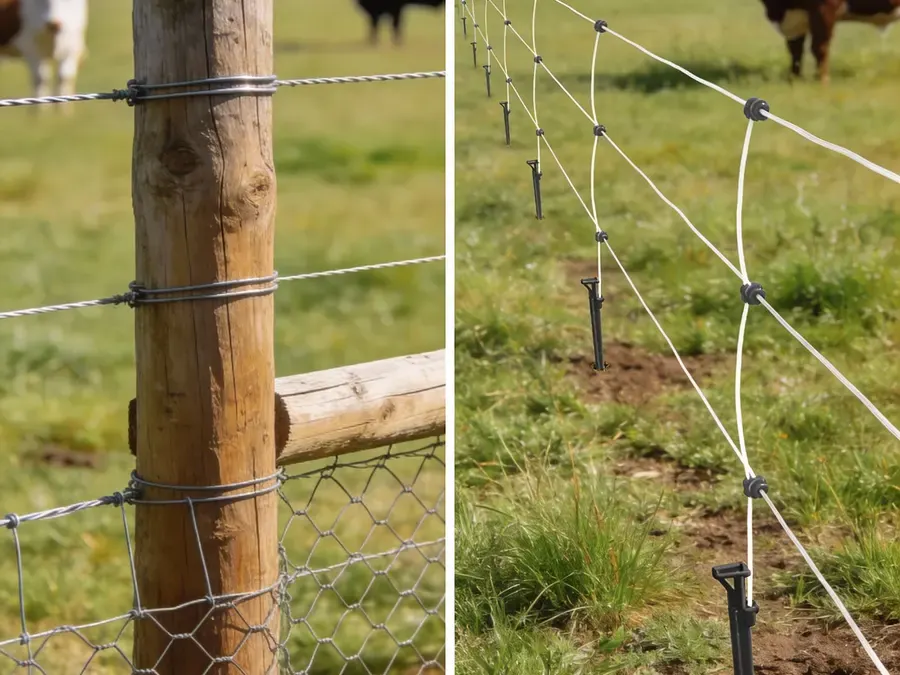

Permanent woven wire and temporary electric fencing shown side by side in cattle pasture
A route or management change can affect more than line length. Recheck fence type, posts, bracing, gate interfaces, electrical components and the records that specify them.

3. Check every affected record

Impact and dependency check
AreaAffected?Record to reviseOwnerDue / status
Route, survey or drawingYes / No / Check________________________
Line length and material quantityYes / No / Check________________________
Gate, brace or access planYes / No / Check________________________
Specification or product dataYes / No / Check________________________
Quotation, order or deliveryYes / No / Check________________________
Permit, utility or responsible reviewerYes / No / Check________________________

Record potential cost, schedule, safety or compliance effects as review flags. Do not use the log itself to decide those effects or who bears them.

4. Keep status, authority and dates separate

Workflow statusProposed / under review / decided
DecisionApproved / rejected / deferred / superseded
Decision authorityName / role per project process
Decision date / evidence____________________________
Effective revision / date____________________________
Conditions / open questions____________________________
Control point“Approved” does not mean “issued,” “issued” does not mean “implemented,” and “implemented” does not mean “verified and closed.” Record each event separately.

Use the status labels and authority route defined for the project. If no authority is documented, leave the decision field open and route the request; do not infer approval from silence, a meeting, a shipment or work observed on site.

5. Issue the revision and preserve acknowledgement

Revision issue and distribution
Affected document / orderOld revisionNew revisionIssued toSent dateAcknowledged / date
________________________________________________
________________________________________________
________________________________________________

Mark the former record “superseded” and retain its identifier. Never erase the earlier value or reuse a revision code for different content.

6. Close implementation with evidence

Implemented by / date____________________________
As-built / receiving evidencePhoto / drawing / record ______
Verified by / role____________________________
Verified date____________________________
Residual actionNone / open item ______
Final statusClosed / superseded / reopened

Questions project teams ask

What belongs in a fence project change log?

Use a unique change ID, date, requestor, exact baseline reference, before-and-after values, reason, impact flags, decision evidence, effective revision, distribution, implementation and closeout evidence.

Is this the same as a change order?

No. A contractual change order may alter scope, price, time or legal obligations and must follow the governing contract and authorized process. This page is a neutral tracking record and cannot create that authority.

Should rejected changes remain in the log?

Yes. Preserve the request, decision, date and reason so the same proposal is not mistaken for an open or approved instruction later.

What if a gate moves after materials are ordered?

Record the old and new gate reference, then flag the drawing, line length, post and brace quantities, hardware, quote or purchase order, delivery instruction and named reviewer for recheck.

When is a change closed?

Only when the project’s process says it is closed. A practical record distinguishes decision, issue, implementation and verification, and links the evidence for each stage.

Evidence and limits

FHWA project-management guidance calls for documented change procedures, roles, recordkeeping, and controls for scope, cost, schedule, risk and quality. An FHWA process review tracked reason, work items, documentation and approval timing, and found that missing dates prevented some changes from being traced end to end. These government construction sources support the record structure, but their federal highway approval rules do not govern a private fence purchase.

Carry the approved revision into the next record

Update the affected quantities and documents before ordering or shipment.

Send the current revision, not a verbal summary.

Include the change ID, affected section, before-and-after values, current drawing or order revision and responsible reviewer.

Send a revision query
